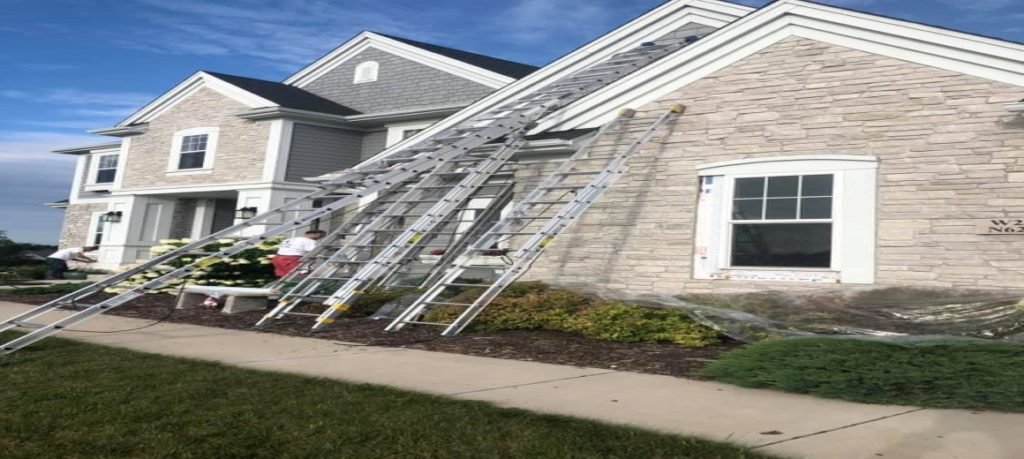

Yes, in most Wisconsin municipalities, re-roofing your house requires a building permit, and that's the default, not the exception. If you're comparing roofing bids right now, the permit question is the fastest way to tell a complete bid from a low-ball one. A contractor who waves it off, leaves it to you, or can't answer who's pulling it is telling you something. This guide covers when a permit is required, who can legally pull one, how long it takes, what an inspector checks, and the exact questions to ask before you sign. Or call John at (262) 352-9525.

Do You Need a Permit to Reroof in Wisconsin?

For a full or substantial re-roof, almost certainly yes. Any Wisconsin municipality that enforces the Uniform Dwelling Code (UDC), the statewide one- and two-family dwelling code, treats re-roofing as permit-required work. The City of Eau Claire spells it out plainly: re-roofing requires a building permit (When is a Permit Required?). "Just replacing the shingles" doesn’t exempt you. Tearing off old roofing and laying new is the textbook definition of work that triggers a permit.

The permit is issued locally, your town or city building department reviews and approves it, but the framework comes from the state. The Wisconsin Department of Safety and Professional Services (DSPS) sets the rules and runs the online system that municipalities feed into. Madison and Milwaukee follow the same UDC framework as Waukesha and Brookfield, though permit timelines and local fees vary city to city. So the inspector you deal with is local; the standard behind their decision is statewide.

We file the permits and meet your WI inspector on-site.Hand it off

Who Can Actually Pull a Wisconsin Roofing Permit

Not just anyone with a ladder and a truck. Wisconsin requires two DSPS-issued credentials before a contractor can pull a residential building permit: the Dwelling Contractor Qualifier (DCQ), the certification that authorizes an individual to apply for permits, and the Dwelling Contractor (DC), the business-level certification required to provide labor on a permitted job. You need both in the chain for the work to be legal.

Here’s what comparison shoppers should care about: these aren’t lifetime credentials. Per the Wisconsin Builders Association, the DCQ renews every two years and requires 12 continuing education credits, while the DC renews annually through the state. When you pull a permit, the local municipality is required to record the contractor’s information and verify both are current. If either has lapsed, the permit doesn’t issue.

Pro tip

Ask every contractor, "Are your DCQ and DC credentials current, and can you give me the numbers?" A contractor who hesitates, deflects, or asks you to pull the permit instead is often working around expired credentials. A current, credentialed contractor pulls permits as routine, it's literally what the DCQ authorizes.

The permit isn't the contractor's burden, it's the homeowner's protection. Anyone telling you to skip it is telling you they plan to disappear when the inspector shows up.

John, T&J co-founder · 14 yrs PM in Waukesha County

The Permit Application Timeline & Cost

This is the part most bids skip, and it’s the part that decides when your crew can actually start. The state’s eSLA system requires a contractor’s credentials to be processed up to one business day before a permit application can be submitted electronically through the Online Building Permit System (DSPS Online Building Permit System). So "we start Monday" isn’t realistic unless the paperwork is already in the system.

After submission, local review takes time. In Waukesha County municipalities, a straightforward re-roof permit often clears within a few business days to a couple of weeks, but busy spring and summer seasons push that longer, plan for a wait of roughly two to four weeks from quote to start when the calendar is full. Permit fees are set locally and vary by municipality and project size; your building department publishes its fee schedule, and a credentialed contractor will fold that fee into the bid rather than surprising you with it later.

Want a real number for your kitchen, not a national average?See my number
Watch out

A contractor who promises an immediate start without mentioning permit timing is either skipping the permit or assuming you won't ask. The credential-processing step alone means a same-day start on a brand-new client is rarely possible.

The practical move is to ask each contractor for their realistic start date with the permit accounted for. The honest answer includes the review window. The low-ball answer pretends the permit doesn’t exist.

Wisconsin's Two-Layer Shingle Rule, and Why It Affects Your Bid

Wisconsin mandates a maximum of two layers of shingles per roof. That single rule can swing your bid by a meaningful amount, and it’s where low-ball quotes hide.

Here’s how it plays out. Picture a 1960s Brookfield ranch that’s already been re-roofed once. If the existing roof has two layers, state rules don’t let a contractor lay a third on top. The roof has to come off, a full tear-off down to the deck, before new shingles go on. Tear-off is labor, disposal, and dumpster time. It’s a real line item.

Now imagine two bids. One includes tear-off; one doesn’t. The cheaper one looks like a bargain until you realize it physically can’t be done legally on a two-layer roof without tearing off first. That’s not a lower price, it’s an incomplete scope that will balloon mid-project or fail inspection. The gap between the two bids is often exactly this line.

The question to ask: "How many shingle layers does my roof currently have, and is tear-off included in this quote?" That one question separates complete bids from optimistic ones.

Metal Roofing? You Need ARB Approval First

If you’re considering metal roofing, there’s an extra gate: approval from the Architectural Review Board (ARB), a local board that reviews exterior changes for compatibility with neighborhood standards, is mandatory before a re-roofing permit can issue.

The catch is timing. ARB decisions aren’t same-week. The board meets on a schedule, your submission goes into a queue, and you wait for a ruling before the permit clock even starts. In 2026 we handled a Brookfield colonial where the ARB initially rejected the homeowner’s metal-roof request; we resubmitted with proper architectural renderings showing the profile and color against the neighborhood, and got approval about six weeks later. A contractor who quotes metal and never mentions the ARB step either doesn’t know it exists or is planning to skip it.

Metal pairs naturally with exterior work that often runs alongside a re-roofing project like trim and fascia. Ask directly: "If I go metal, have you handled ARB approval in my municipality before, and how long did it take?"

Pre-1978 Homes: Lead-Safe Rules Add Another Layer

If your home was built before 1978, there’s a requirement most low-ball bids ignore. Under ch. DHS 163, Wisconsin’s lead-safe renovation rule, work that disturbs 20 sq. ft. or more of exterior paint on a pre-1978 dwelling triggers mandatory lead-safe training and certification (DSPS Online Building Permit System). Roofing work on an older home almost always crosses that threshold once you factor in fascia, soffit, and edge work.

What that means in practice: the contractor must hold lead-safe renovation certification, and the crew has to follow specific containment and disposal procedures the EPA’s Renovation, Repair and Painting program lays out. That’s labor and materials a non-certified crew doesn’t price in.

Code note

ch. DHS 163 applies to dwellings built before 1978 once a project disturbs 20 sq. ft. or more of exterior paint (DSPS Online Building Permit System). If your contractor doesn't mention lead-safe compliance on an older home, the scope is legally incomplete, and the liability can land on you, not them.

We quoted a 1974 home in Waukesha where the homeowner’s first bid missed lead-safe compliance entirely. We caught it, added the line, and the job passed inspection on the first try, which is the whole point of getting it right up front. For a pre-1978 home, ask: "Is your crew lead-safe certified, and is that in this scope?"

What Happens During Inspection

A permitted re-roof ends with a municipal inspection, and knowing what the inspector looks for helps you understand why a complete bid costs more. The inspector verifies the work matches the permitted scope: proper tear-off where required, sound roof decking, correct underlayment and ice-and-water shield at the eaves, properly installed flashing around chimneys and valleys, and adequate ventilation. On older homes, they’ll also confirm lead-safe procedures were followed.

Common fail points are predictable: missing or undersized ice-and-water shield, flashing that’s been reused instead of replaced, decking left in place when it should have been swapped, and, the big one, a third layer of shingles laid over an existing two layers in violation of state rule. A low-ball bid that cut these corners doesn’t pass. The work gets flagged, and the homeowner is the one stuck arranging the redo.

The number

A re-roof on a two-layer house without tear-off can't legally pass inspection, the third layer fails on sight.

When a contractor pulls the permit, they own the inspection. When you pull it, you own the failure. That’s the quiet reason credentialing matters.

What a Complete Roofing Bid Looks Like vs. a Low-Ball One

This is the whole ballgame for a three-bid shopper. The lowest number on paper is rarely the lowest number you actually pay.

A complete roofing bid includes:

A low-ball bid omits:

  • The permit, or quietly leaves it for you to pull
  • Tear-off when your roof needs it
  • The ARB step on metal
  • Lead-safe compliance on an older home

So when you’re staring at a higher quote and a lower one asking, "Why is yours more?", the honest answer is usually that the gap is these line items. The cheaper bid didn’t find a magic discount. It left things off the page that the job still requires, and you’ll pay for them either way: as a planned line item now, or as a change order, a failed inspection, or a denied insurance claim later.

Wisconsin even codified the warning. Under 101.65(lr), municipalities enforcing the UDC must give permit applicants a cautionary statement about contractor bonding and insurance (DSPS Online Building Permit System), the state effectively telling homeowners to check this before they sign.

Not sure if your bid is complete? Call (262) 352-9525 for a free scope review, we’ll spot the gaps before you sign.

How T&J Handles Permits on Every Roofing Project

We pull permits as part of standard scope, never a surprise add-on, never something we hand back to you. John handles all permit coordination and A-to-Z communication on every project, so you’re not the one chasing the building department or sitting on hold. That’s part of what you’re hiring: the paperwork done right, on time, by someone whose name is on it.

T&J carries the required Wisconsin credentials, and because we’re a father-son business, the owners are on every job, there’s no anonymous crew showing up without context. Roofing often dovetails with full-scope remodeling projects in Waukesha County when the time is right, and we’ll flag where those scopes overlap instead of pretending they don’t.

If you want to walk through your roof’s condition and what a compliant, complete scope looks like, that conversation is free, no cost, no obligation. We serve homeowners across Brookfield and the surrounding Waukesha County area and the Greater Milwaukee metro.

Frequently asked questions

Why does Wisconsin have a two-layer shingle rule?

Wisconsin caps roofs at two shingle layers because weight and fire safety both become problems past that point. Each layer adds dead load the roof structure was never engineered to carry, and stacked layers trap heat and hide deck rot from inspection. So when your roof already has two layers, the state requires a full tear-off before new shingles, not to inflate your bill, but because a third layer can overload framing and conceal the very decay an inspector is supposed to catch.

What happens if my contractor doesn't pull a permit?

Unpermitted work creates problems at resale, because title companies and buyers' inspectors increasingly flag permit-history gaps. More immediately, if the roof fails and you file a homeowner's insurance claim, the insurer can deny it on the grounds the work wasn't code-compliant. And the municipality can order the work torn off and redone at your expense, so the permit isn't friction, it's the mechanism that makes the contractor's work legally defensible.

Can I pull the roofing permit myself in Wisconsin?

Some Wisconsin municipalities let you pull a permit on your own primary residence, but the contractor doing the work still needs current DC certification to legally provide labor. The deeper issue is liability: if you pull the permit and the work fails inspection, the failure is yours, not the contractor's. Most credentialed contractors pull their own permits because the DCQ authorizes them to, so if yours asks you to do it instead, that's worth questioning.

How long does ARB approval take for metal roofing?

ARB approval isn't same-week, because the Architectural Review Board meets on a fixed schedule and reviews how your roof's profile and color fit the neighborhood. A clean submission with proper renderings can clear in a few weeks; a rejection that requires resubmission, as we saw on a 2026 Brookfield colonial, can stretch to six weeks or more. That's why a metal-roof bid that ignores the ARB step is a timeline problem waiting to happen.

Does Wisconsin require a permit for minor roof repairs?

Minor repairs, patching a few shingles, fixing chimney flashing, typically don't trigger a permit in most Wisconsin municipalities, because the threshold is generally a full or substantial re-roof. But "minor" is defined locally, and the line blurs when a small repair grows mid-project. The safest move is to have your contractor confirm with the local building department before work starts, especially if the repair covers a significant portion of the roof.

Why do lead-safe rules apply to roofing on older homes?

Because homes built before 1978 likely contain lead-based paint, and disturbing it sends lead dust into soil and air where children are most at risk. Under ch. DHS 163, any work disturbing 20 sq. ft. or more of exterior paint requires lead-safe certification and specific containment and disposal procedures (DSPS Online Building Permit System). Roofing on an older home almost always crosses that threshold once fascia and soffit work is included, so a bid silent on lead-safe compliance is missing a legally required scope item, not an optional one.
